PEMB Erection Timeline: A Phase-by-Phase Breakdown

Erecting a pre-engineered metal building (PEMB) is often billed as a straightforward construction process, but as any seasoned general contractor knows, the devil is in the details. Like traditional buildings, PEMBs hide critical details that can trip you up.

A clear, practical PEMB erection timeline helps you plan labor, order building materials at the right time, and coordinate crews without costly delays.

Let's break down a typical timeline by phase, unpack the factors that push schedules off course, and share pro tips for keeping your project on track.

What Factors Influence the Pre-Engineered Building Erection Timeline?

Before diving into the step-by-step schedule, let’s examine the key variables that can shorten or stretch out your pre-engineered metal building schedule:

Building Size and Complexity

  • Square footage: Larger structures need more coordination. A 5,000 sq ft metal structure goes up much faster than a 50,000 sq ft warehouse. Every doubling of floor area requires more coordination on material delivery, staging, and joint alignment.

A PEMB warehouse in construction.

Construction of a PEMB warehouse.

  • Architectural features: Plan accordingly in the design phase of your construction process. Overhangs, mezzanines, integrated offices, or insulated roof panels add days to erection compared to a simple, clear-span building design.

Regional Weather Conditions

  • Rain and storms: Wet ground can stall foundation work, and high wind load can delay lifting steel frames.

  • Hot or cold extremes: Temperature swings affect concrete curing and can limit safe work hours for crews.

Crew Size and Experience

  • Labor pool: A dedicated, experienced crew of 6–8 skilled erectors will move through framing and roof panels in half the time it would take a less-seasoned 4-person team.

  • Turnover: Consistent crew assignment during the planning phase helps project managers decrease the learning curve the learning curve down. Swapping out workers mid-project often costs extra setup time.

Site Readiness and Permitting

  • Permits in hand: Delayed inspections, or missing permits or building codes, can halt site prep, adding unpredictable construction time.

  • Utility connections: Underground utilities, storm drains, and slab penetrations must be planned and excavated before steel delivery.

Understanding how these factors affect your specific conditions sets realistic expectations for your steel building erection time.

A Phase-by-Phase PEMB Erection Schedule

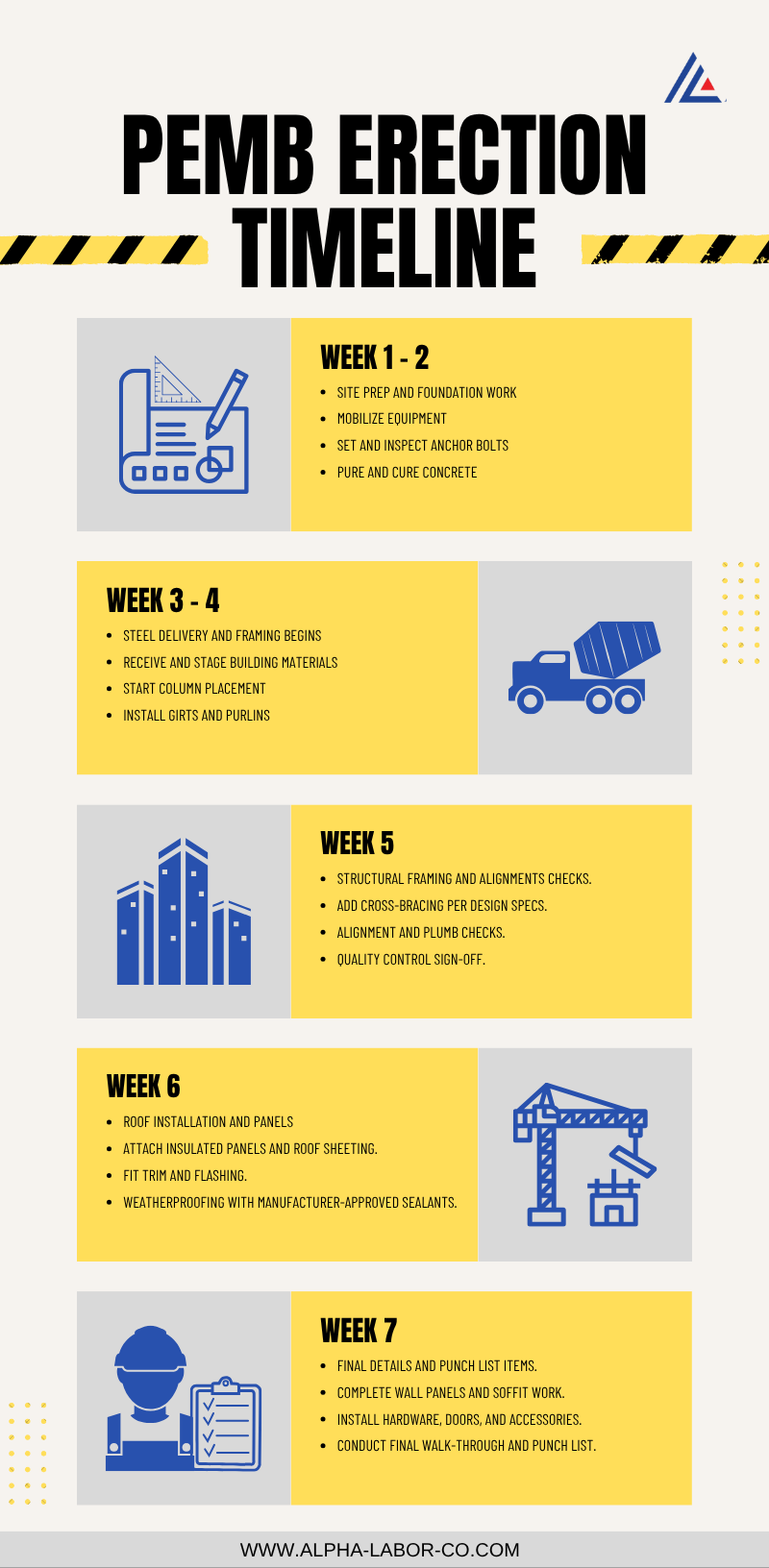

Below is a 7-week sample PEMB erection timeline for a moderately sized industrial building (approx. 10,000 sq ft). Adjust based on your project’s scale, complexity, and local conditions.

Week 1–2: Site Prep & Foundation Work

  • Mobilize equipment: Bring in excavators, compaction gear, and formwork.

  • Set and inspect anchor bolts: Accurate bolt placement is critical; allow 1–2 days for leveling and inspection.

  • Pour and cure concrete: The typical cure time is 5–7 days. Plan for a mid-point inspection to stamp off slab tolerances.

Alpha Labor Co. Pro Tip:
Schedule your pre-pour inspection two weeks ahead of foundation work to ensure building permits and civil drawings are ready for your steel building project.

Week 3–4: Steel Delivery & Framing Begins

  • Receive and stage building materials: Lay frames, girts, purlins, and roof panels near the foundation in the logical sequence of your steel structure.

  • Start column placement: Erect primary columns first, plumb and brace.

  • Install girts and purlins: Work outwards from the centerline. A crew of four can install roughly 400 ft of purlins per day.

Week 5: Structural Framing and Alignment Checks

  • Cross-bracing: Add wind and seismic bracing per design specs.

  • Alignment and plumb checks: Walk the entire frame, making micro-adjustments. This process often uncovers bolt torque adjustments or shim requirements.

  • Quality control sign-off: Involve your structural engineer in a mid-erection review to minimize rework later.

Scheduling Note:

Closely align your steel delivery schedule with your crew’s availability to avoid layovers. Late or early truck arrivals can disrupt the pre-engineered metal building schedule by days.

Alpha Labor Co. Pro Tip:
Invest in a rugged laser level for faster, more accurate alignment checks. It pays off in reduced punch-list items.

Week 6: Roof Installation and Panels

  • Roof sheeting: Attach insulated panels or metal roof sheets. Expect 1–2 panels per man-hour for standard 26‑gauge metal.

  • Trim and flashing: Fit ridge caps, eave trims, and gutter systems.

  • Weatherproofing: Seal overlaps and penetrations with manufacturer-approved sealants.

Scheduling Note:

Plan roof work for calm-weather windows and keep close tabs on the forecast. Extreme weather not only compromise safety but also slow down roofing crews significantly.

Week 7: Final Details & Punch List Items

  • Wall panels and soffits: Complete wall panels, other vertical sheeting, and any architectural soffit work.

  • Hardware, doors, and accessories: Install overhead doors, personnel doors, and louvers.

  • Walkthrough and punch list: Conduct a thorough client walkthrough. Address misaligned panels, missing closure strips, or minor painting touch-ups.

Alpha Labor Co. Pro Tip:

Book your final inspection two weeks in advance—most municipalities have busy inspection calendars, and you want that certificate of occupancy on schedule.

How to Keep Your PEMB Project On Schedule

A reliable PEMB erection timeline is only as good as your coordination efforts. Here are three actionable strategies for your construction project:

  1. Align delivery with crew arrival: Create a detailed truck uno order that matches the erection process. This prevents crews from waiting or rummaging through mismatched bundles.

  2. Pre-schedule inspections: Don’t wait for the slab to cure—lock in your engineer and municipality inspection slots early in the project.

  3. Communicate sequencing clearly: Distribute a daily erection plan to all subcontractors. A shared cloud-based schedule (e.g., Procore or PlanGrid) keeps everyone on the same page.

Signs Your Project May Be Falling Behind

Even with the best planning, delays happen. Watch for these red flags:

  • Late structural component delivery: If one bundle is missing or mislabeled, halt framing until it’s resolved. Jammed columns are time sinks.

  • Misaligned anchor bolts: Overlooked bolt placement issues often result in a complete teardown of columns, adding days to your timeline.

  • Site staging issues or weather stalls:

Muddy or cluttered staging areas force crews to spend extra time handling and moving materials.

When you spot these issues early, you can reassign crews to other tasks (like punch-list items or interior pre-work) to maintain momentum.

Ready to Hit Your Target Dates?

A clear, phase-by-phase PEMB project timeline is your roadmap to avoiding surprises, staying on budget, and delivering value to your clients. But even the best-laid plans benefit from an experienced partner.
